Share on Facebook
Share on Linkedin
Email this link
Due to the ongoing situation with the COVID-19 pandemic, this Open House event has been postponed until further notice.
The Town of Midland will be holding a King Street Rejuvenation - Phase 2 Pre-Construction Open House on:
When: Thursday, March 19, 2020 from 4 p.m. to 8 p.m.
Where: North Simcoe Sports & Recreations Centre - Community Hall
527 Len Self Boulevard, Midland
*This Open House is drop-in style. There will be no presentation.*
The purpose of this Open House is to:
- Coordinate the upcoming Phase 2 of the rejuvenation project with businesses and downtown residents;
- Answer questions and explain more about Phase 2, with Town Staff, Tatham Engineering Staff and Arnott Construction Staff available; and
- Provide construction drawings for the upcoming work, construction sequencing plans, and Traffic Control plans.
It is recommended that all King Street area businesses attend!
Share on Facebook
Share on Linkedin
Email this link
The intersection of Bayshore Drive and King Street is now open, after the traffic lights were given a green light by inspectors today! With that, the Phase 1 Construction of the King Street Rejuvenation is now complete!
Phase 2 of the rejuvenation will begin in Spring 2020. Stay tuned for updates as spring gets closer

Share on Facebook
Share on Linkedin
Email this link
The Fall 2019 Phase of the King Street Rejuvenation is nearing completion, as today the road closure for Bay Street West at King Street was removed allowing traffic to flow north of Dominion Avenue to Bay Street West. The main portion of work left to be completed is the installation of the traffic lights at Bayshore Drive and King Street. Depending on delivery of those materials/equipment, the work is expected to be completed within the next two weeks.

Share on Facebook
Share on Linkedin
Email this link

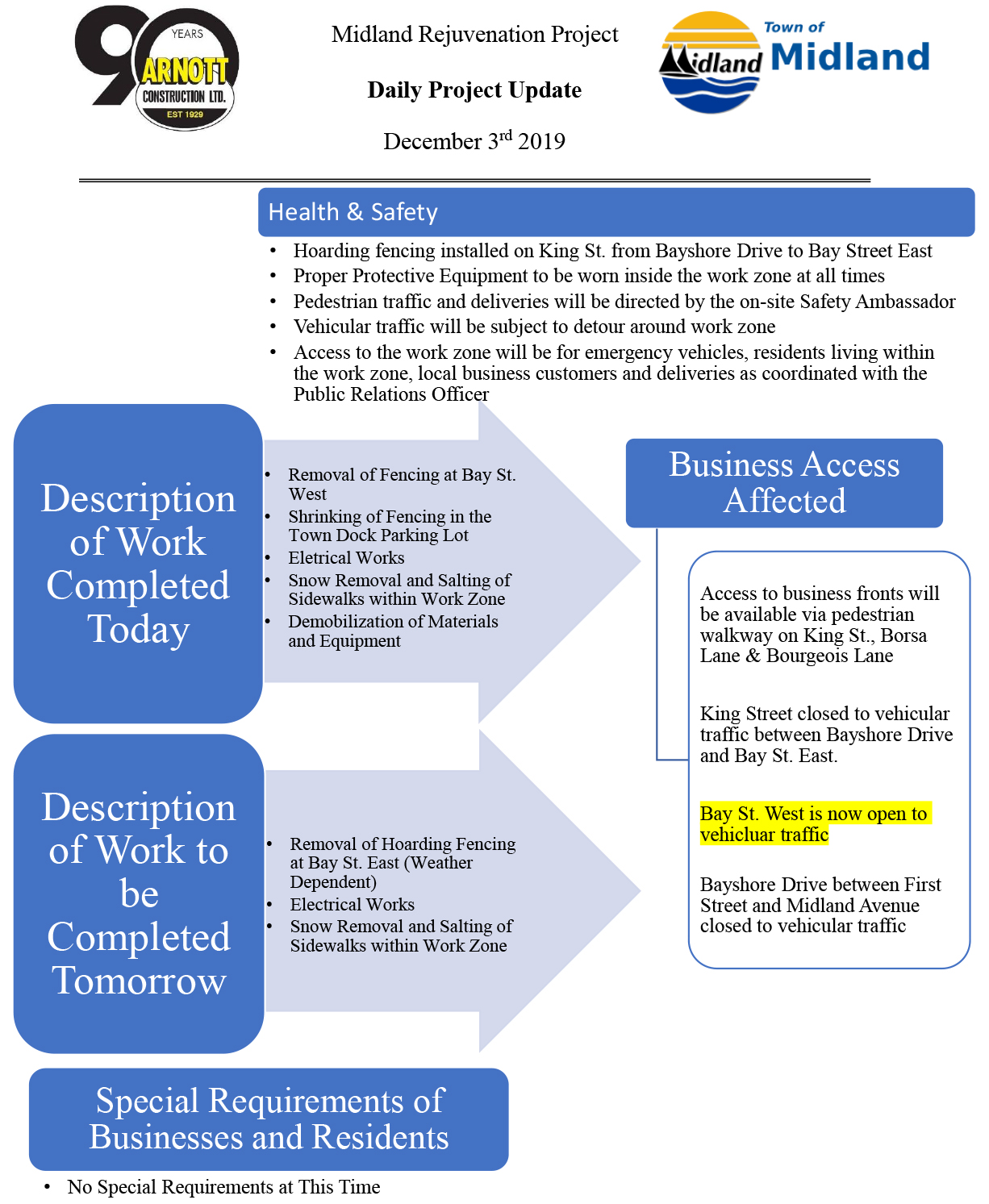

The King Street Rejuvenation - Phase 1 work is nearing completion for the Fall 2019 phase.
Work completed to date:
- All underground water, sanitary and storm work is complete.
- All curb work is complete.
- Road has been constructed sub-grade elevation.
Work to be completed:
- Underground/overhead electrical work.
- Road grading, paving and line painting.
- Sidewalks to be temporarily-paved with asphalt for the winter.
- Construction fencing and signage removal once safe to do so.
The snowy weather arrived earlier than anticipated, but crews have been hard at work to complete this project on schedule. Weather-permitting, the plan is for the Fall 2019 Phase to be completed by the end of November.
Share on Facebook
Share on Linkedin
Email this link
Project Update from Arnott Construction LTD. on what works was completed this past week, and what work is scheduled for the week of October 28, 2019.

Share on Facebook
Share on Linkedin
Email this link

Project Update from Arnott Construction LTD. on what works was completed this past week, and what work is scheduled for the week of October 21, 2019.

Share on Facebook
Share on Linkedin
Email this link

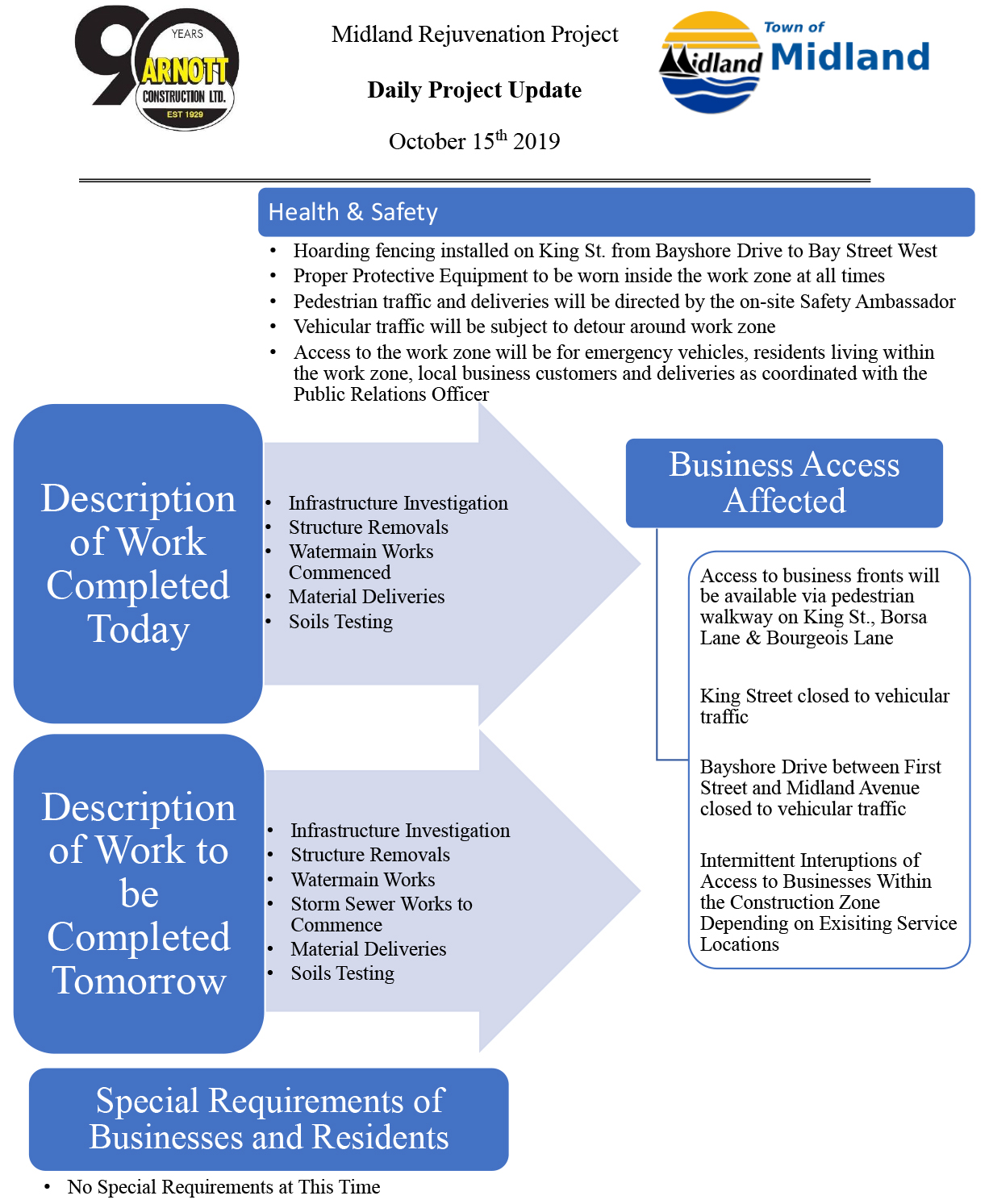

The King Street Reconstruction is moving along. Arnott Construction continues to remove underground structures and other work, and they have now reached a point where work has commenced on the underground watermains. Tomorrow (October 16) work on the storm sewers is to commence.

Share on Facebook
Share on Linkedin
Email this link

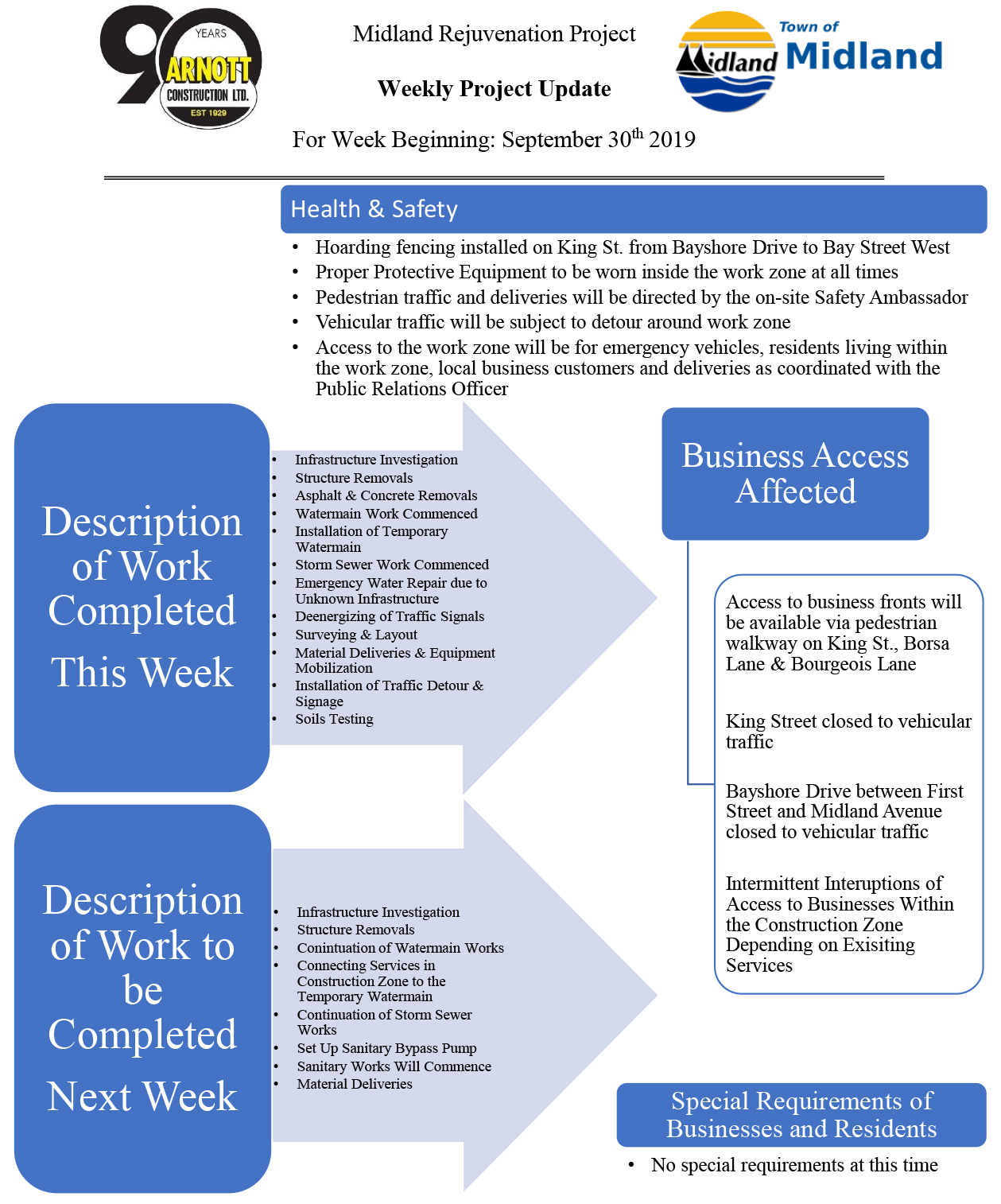

Project Update from Arnott Construction LTD. on what works was completed this past week, and what work is scheduled for the week of September 30, 2019.

Share on Facebook
Share on Linkedin
Email this link
Project Update from Arnott Construction LTD.:

Share on Facebook
Share on Linkedin
Email this link

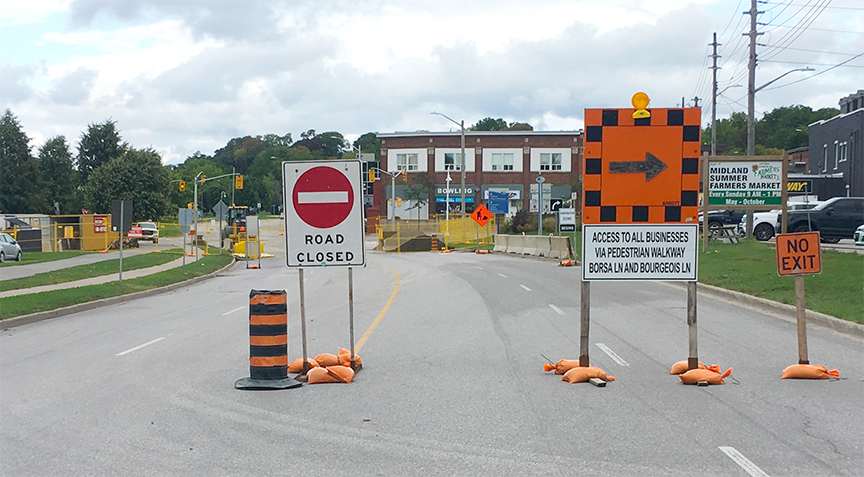

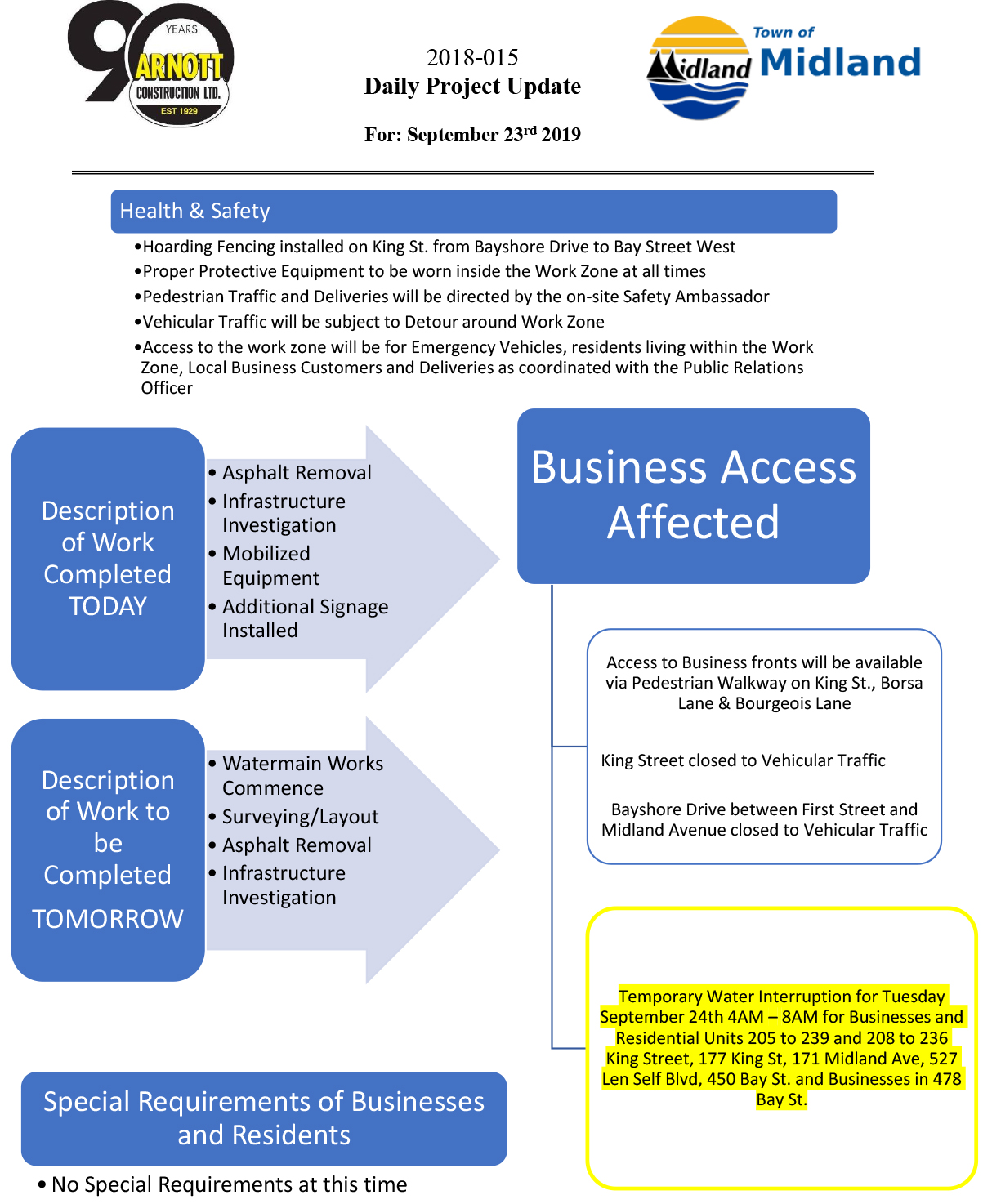

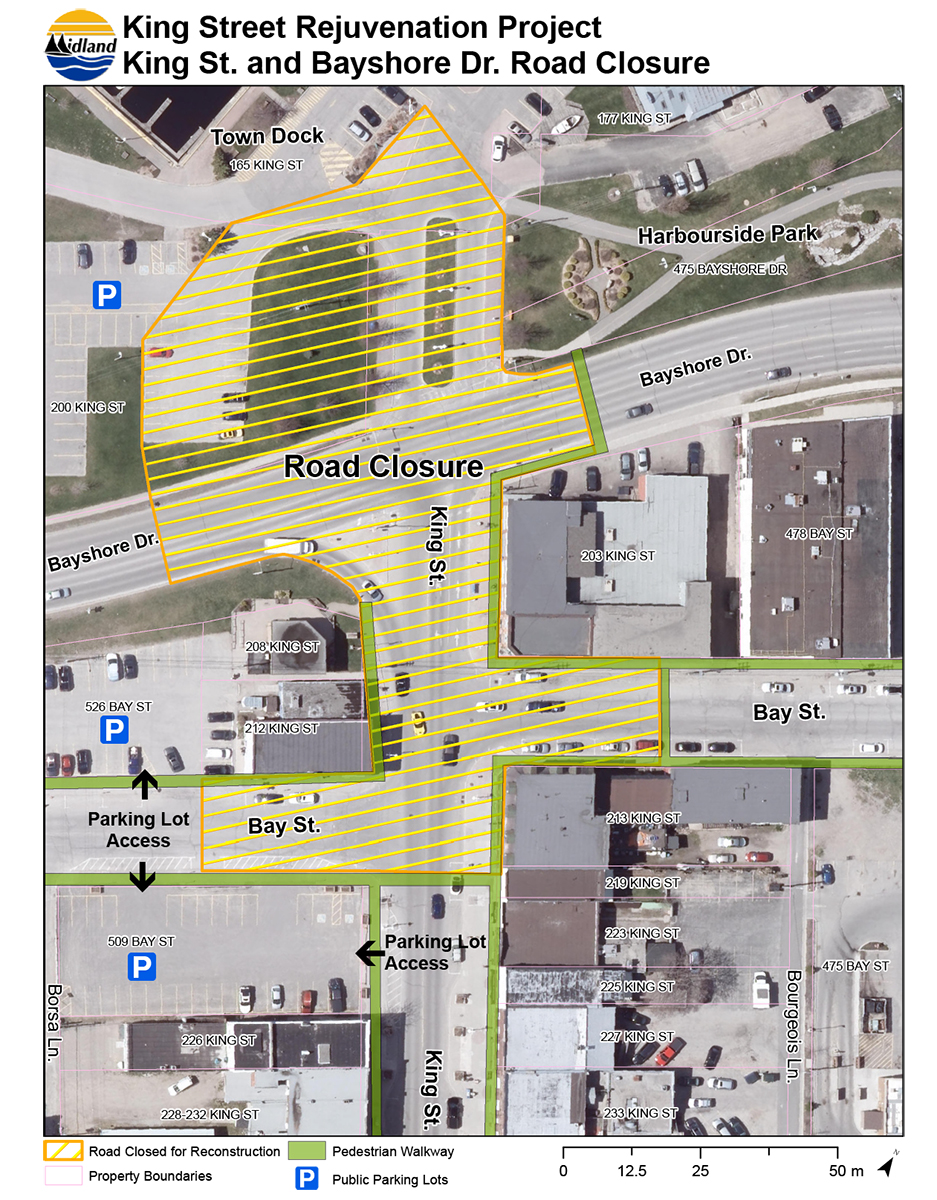

Please be advised that we have updated the road closure map. This updated map more-clearly indicates where drivers can access the parking lots in this area, and also shows where the pedestrian walkways (sidewalks) are throughout the area. For a PDF version of the map click here.
The Town of Midland would like to ask that drivers not cut through the Midland Harbour parking lot to avoid the road closure on Bayshore Drive. We understand that Midland Avenue has been difficult to use during the re-paving work, however it should be completed today (September 23) which should allow for a smoother flow of traffic around the work zone. If drivers continue to cut through this lot, a barrier will be installed.
